Brown Avenue Parking Structure Expansion

Project Phase

Planning
Design
Construction
Completed

Project Summary

In the 2019 bond election, voters approved Project No. 63 to expand parking in Old Town Scottsdale. The funds will be used to add two levels to the Brown Avenue Parking Structure.

Project Information

Budget: $20,900,000

Sponsoring Division: Tourism & Events

Funding Source: Bonded

Project Location: First St. and Brown Ave.

Contact Information

Roger Berna
Project Manager
480-312-7845
Roger Berna

Large tan commercial building at a street corner with sidewalks, small trees, parked cars, and a few pedestrians under a blue sky.
From the corner of Brown Ave and First Street looking southwest
Scottsdale Corral parking structure entrance with a brick facade, parked and passing cars, small trees, and pedestrians along the street.
Parking Structure Entrance on Brown Avenue
Street view of Scottsdale Corners and the Art Wall storefronts, showing brick and stucco facades, small trees, pedestrians, and a parked car along the curb.
View from 1st Street looking west
Modern three-story mixed-use building with stucco and vertical metal siding along a tree-lined city street.
View from 2nd Street looking west

The current parking corral has one level or surface-grade parking and one level of underground parking. Two additional levels of parking will be added with 185 parking stalls.

Community outreach meetings helped shape the design of the structure’s western storefronts. A mix of materials will create the look of individual buildings. The top level will be set back from Brown Avenue, with shaded sidewalks designed to reflect Old Town’s character.

Public art currently on-site will be preserved, and a new installation will face Second Street.

Construction began in July 2026, and the new parking stalls will be available in the spring of 2027. Work will continue to finish elements of the garage through the summer of 2027.

Construction Update

Installation of the precast concrete panels is ahead of schedule. The project’s second phase of construction began in early September and is focused on installing precast concrete columns and panels that will form the framework of the expanded parking structure.

Precast work is now complete on the north side of the garage along 1st St. and has moved to the south side of the garage.

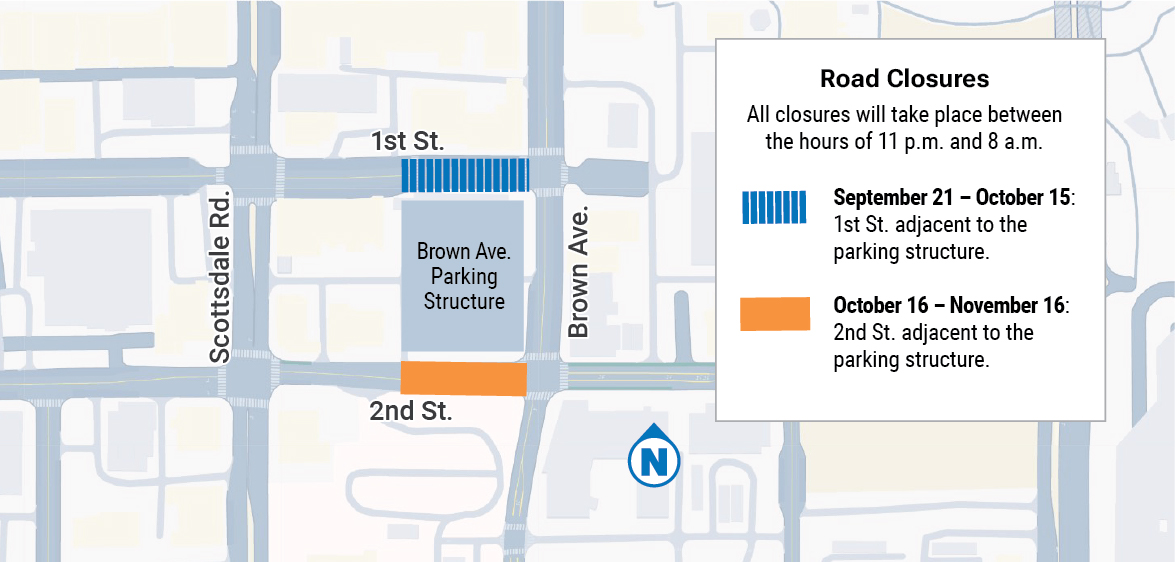

2nd St. will be closed along the south side of the parking structure Oct. 16 – Nov. 16. The closure is needed due to the size of the crane needed to lift the large precast panels and public safety.

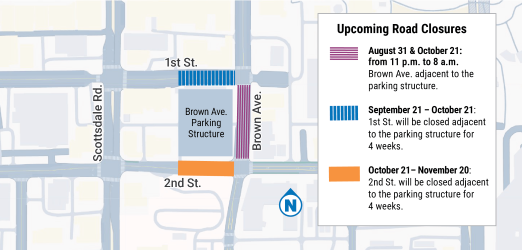

Map showing upcoming road closures on 1st St., 2nd St., and Brown Ave. near the parking structure.

The precast erection phase is anticipated to take approximately eight weeks. To minimize impacts to the public, neighboring businesses, and surrounding areas, the precast panels will be installed nightly between the hours of 11 p.m. and 7 a.m.

The large precast panels are being fabricated off site and will be delivered to the project site each night, where they will be lifted into place by crane. While the precast erection phase will have the greatest impact on the public, this construction method allows the work to be completed more efficiently, reducing the overall duration of these impacts.

Tentative Construction Schedule

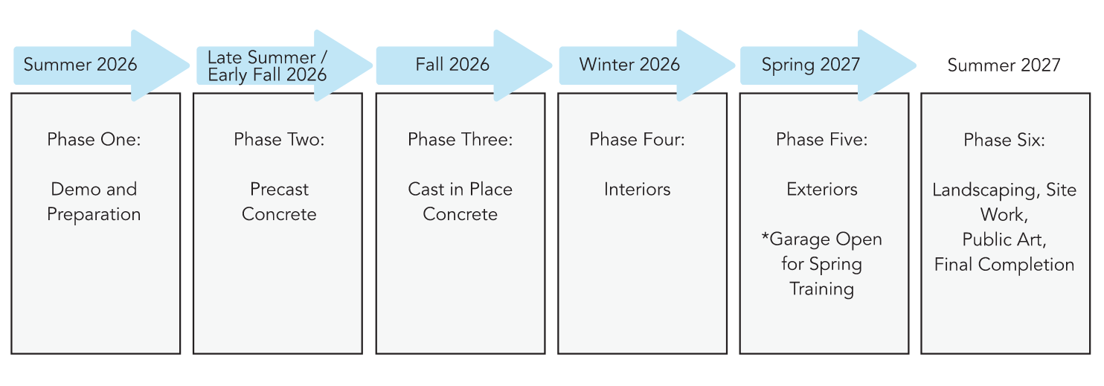

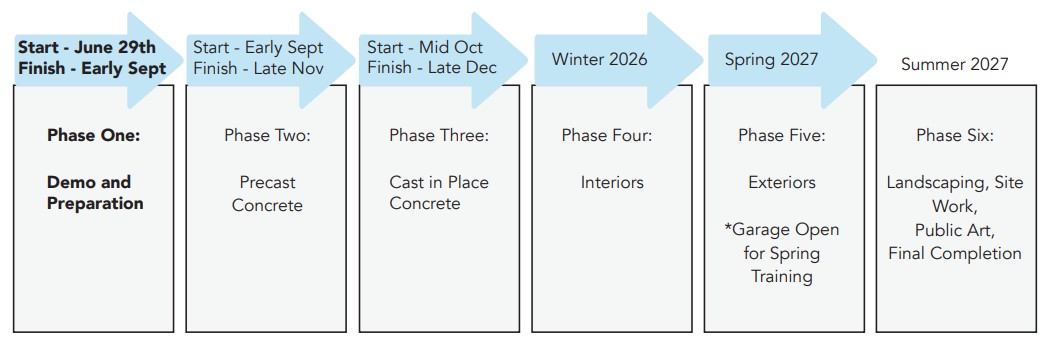

Construction timeline showing six phases from Summer 2026 to Summer 2027: demo and preparation, precast concrete, cast in place concrete, interiors, exteriors with garage open for spring training, then landscaping, site work, public art, and completion.

Community Outreach

Public Meeting #3 – March 12, 2026

A third public meeting was held to review the final design and learn about construction sequencing for the Brown Avenue Parking Structure Expansion at 9 a.m. on Thursday, March 12, at the Civic Center Library Auditorium. View the presentation (PDF) and let the public artist know what you think is important about Old Town Scottsdale using this comment form.

Public Meeting #2 – September 2025

View the presentation (PDF) for the second public meeting, which was held at 8:30 a.m. on Thursday, Sept. 18, at the Civic Center Library Auditorium, located at 3839 N. Drinkwater Blvd. At this meeting two floor plans were presented; floorplan which had a single level setback and floorplan B which has a double level setback on the east side of the parking structure along Brown Ave. Additionally, two exterior design options were presented Western and Adobe.

Public Meeting #1 – May 2025

A public meeting to kick off the design process was held at 8:30 a.m. on Thursday, May 22, at the Civic Center Library Auditorium. View the presentation (PDF) to see what was presented.

Project Schedule

February 2025Design Contract Approved by City Council and Design Work Begins
Spring 2025Public Meeting #1
Late Summer/Early Fall 2025Public Meeting #2
Early 2026Public Meeting #3
Summer 2026Construction Begins
Spring 2027New Parking Stalls Open
Summer 2027Construction Complete

Project History

In 2017 the city commissioned a study of the existing structure and the feasibility to add additional levels to the parking structure. Currently the structure is designed to accommodate up to three additional levels.

The study confirmed that the existing structure, originally constructed in 2004, was in good condition and capable of supporting additional floors. It recommended two options: Option 1, add three levels and eliminate the east/west alley access, or Option 2, add two levels with an elevated second level allowing east/west access for high profile vehicles.

At the April 16, 2024, City Council Work Study session, staff presented the expansion of the 1st Street and Brown Avenue parking structure along with two other options to expand parking in the most needed areas of Old Town.

On July 1, 2024, Council gave direction to proceed with the addition of two levels to the existing City-owned parking structure at 1st Street and Brown Avenue. An additional structure will be built in the Northeast quadrant of Old Town with a different funding source.

On Feb. 11, 2025, the City Council approved a Design Build Manager of Chasse Building Team to design the expansion of the Brown Avenue Parking Structure.

Last Updated: Nov 3, 2026
